Project Setup
Define the project goal, scope boundaries, milestones, owners, assumptions, decisions, and communication rhythm.
A fictional aircraft rehaul project-controls example showing how a complex recovery effort can be organized with clear scope, milestones, ownership, risk tracking, work packages, and practical reporting.
Define the project goal, scope boundaries, milestones, owners, assumptions, decisions, and communication rhythm.
Keep vendors, internal owners, approvals, materials, dependencies, changes, and follow-up actions visible.
Use dashboards, schedules, work packages, and RAIDD tracking to make progress and risk easier to manage.
Give leadership a straightforward view of what is done, what is blocked, what changed, and what happens next.
The screenshots below use the existing static PNG assets in the repository root.

A summary view for progress, milestones, budget or effort signals, risks, and next steps.

A schedule view that makes phases, dependencies, timing risk, and upcoming milestones easier to discuss.

A work-package view that clarifies ownership, status, dependencies, and follow-up actions.

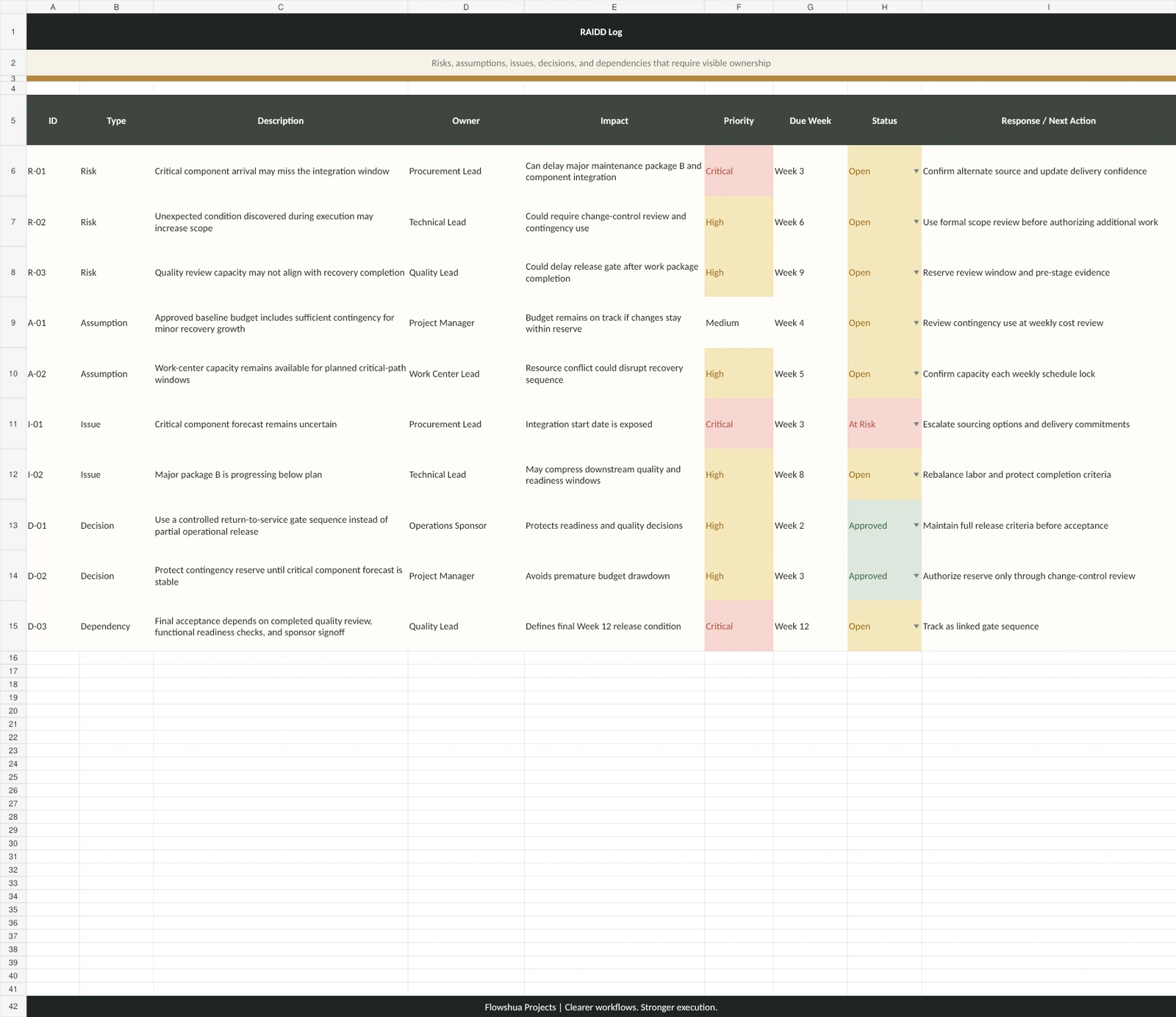

A risk, action, issue, decision, and dependency log that turns project noise into owned follow-up.

Downloads are optional and kept separate from the main case-study cards so visitors can review the static page first.
No workbook or PDF download is required for this case-study page.
